Financials · Protect margin

Cost control that catches it before it costs you.

Budget, prime contract, commitments, change, and invoicing by cost code, synced with your accounting system. Ledger reconciles every invoice against the schedule of values and field progress, prices change events, and explains every variance in plain words.

Fulcrum Budget by cost code with original budget, approved changes, committed costs, and projected cost at completion.

Tools in Financials

7 tools, one set of records.

  • Budget

    Budget, commitments, and forecast by cost code.

    Ledger · Cost Controller

  • Prime Contract

    Owner contract, schedule of values, and owner change orders.

    Ledger · Cost Controller

  • Commitments

    Subcontracts and purchase orders with compliance tracking.

    Ledger · Cost Controller

  • Change Events

    Potential changes from RFIs, field conditions, and owner requests.

    Ledger · Cost Controller

  • Change Orders

    Owner and commitment change orders with approval chains.

    Ledger · Cost Controller

  • Invoicing

    Owner pay applications and subcontractor invoices.

    Ledger · Cost Controller

  • Direct Costs

    Invoices, expenses, and payroll outside commitments.

    Ledger · Cost Controller

Forecasts you can explain

See budget, commitments, actuals, and projected cost at completion by cost code. Ledger explains every variance over your threshold in one sentence, like drywall labor running 11% below planned productivity.

  • Projected cost at completion by cost code
  • Variance explanations in plain words
  • Snapshots and modifications with full history

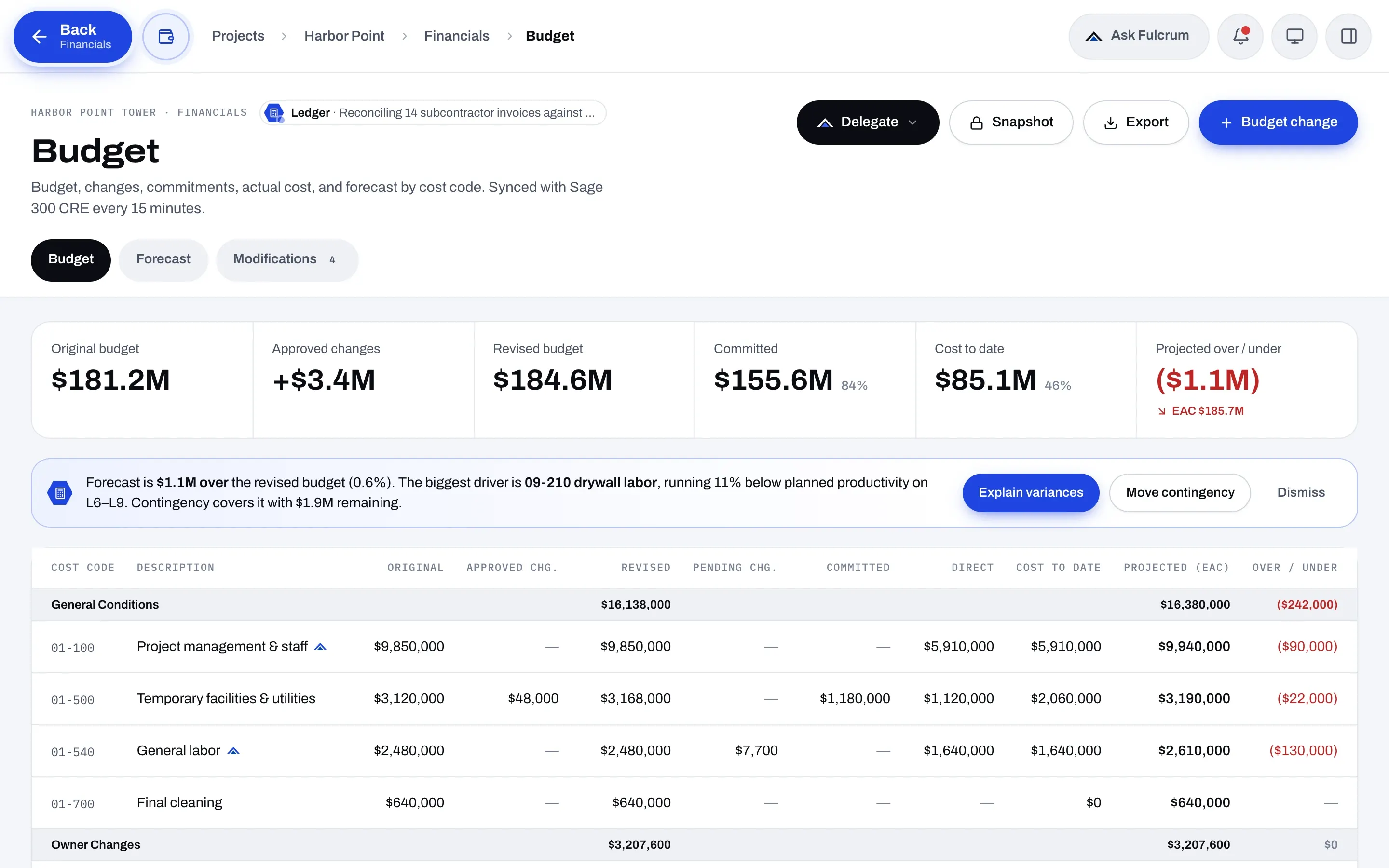

Budget table in Fulcrum with a forecast callout explaining the biggest variance driver.

Invoices checked against the field

Ledger reconciles subcontractor invoices against the schedule of values and field counts, holds anything that does not match, and preps the owner pay application on schedule.

  • Invoices reconciled against SOV and progress
  • Mismatches held with the evidence attached
  • Pay app prep every month on the date you set
Fulcrum Invoicing with owner pay applications and subcontractor invoices under review.

Change, from first sign to signed change order

Potential changes start from RFIs, field conditions, and owner requests. Ledger prices them against subcontract rates and T&M tickets, and change orders route for approval by dollar threshold.

  • Change events linked to their source
  • Pricing checked against subcontract rates
  • Approval chains by dollar threshold

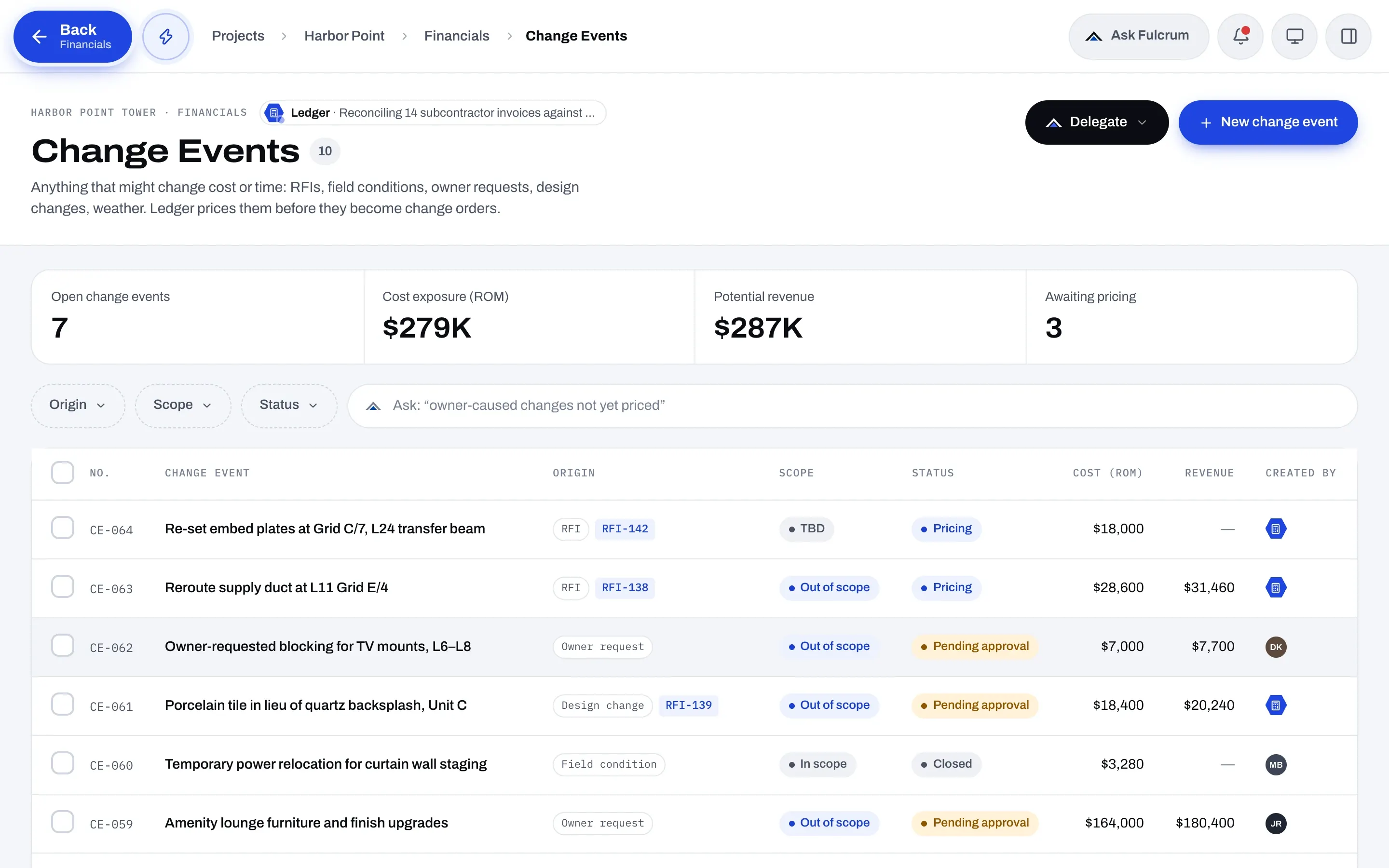

Fulcrum Change Events log with source, status, and estimated cost.

Agents in Financials

The agents who work here.

Agents work inside Financials with the same records and permissions as your team. You choose how much they do on their own.

  • Ledger

    Cost Controller

    Working

    Reconciles invoices against schedules of values, prices change events, tracks commitments, and forecasts cost at completion.

    Now

    Reconciling 14 subcontractor invoices against SOV

    Autonomy
    Act with approval
    Triggers
    • A subcontractor invoice is submitted
    • A change event is created
    • Monthly on the 20th, pay app prep
    Works in
    BudgetCommitmentsChange EventsInvoicing
  • Beacon

    Owner Reporting

    Paused

    Assembles the monthly owner report: progress narrative, photos, cost and schedule summaries, and the risk register, led by the decisions the owner needs to make.

    Paused

    Paused while the owner’s new report format is set up

    Autonomy
    Suggest
    Triggers
    • Monthly on the 25th, owner report draft
    Works in
    InsightsPhotosBudgetSchedule
How Fulcrum agents work

FAQ

Financials questions

Have a question that is not here? Ask us

Does Fulcrum replace our accounting system?

No. Fulcrum runs project financials and syncs job cost, commitments, and AP with your ERP, including Sage 300 CRE, Viewpoint Vista, and QuickBooks Online.

Can an AI agent approve a payment?

No. Committing or releasing money is on the list of actions agents can never take. Ledger prepares and reconciles, and a person with payment authority approves.

How are change order approvals routed?

Through approval chains you set in Workflows, for example a project manager up to $50,000 and a project executive above that, with every step recorded.

See Financials on your projects.
